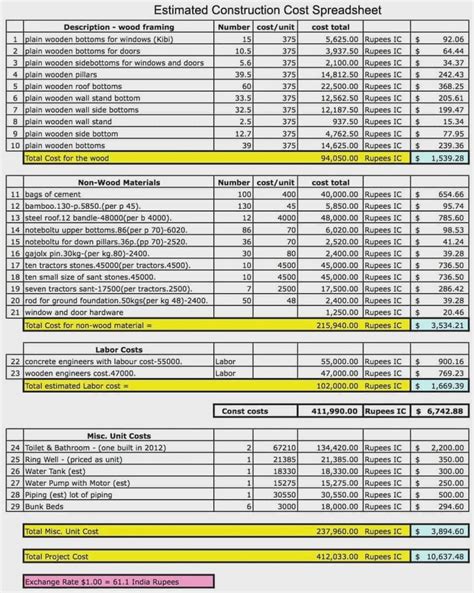

How To Estimate Labor Costs For Construction: A Contractor’s Guide
Accurately estimating labor costs for construction requires breaking down project scopes into granular task units, applying localized wage rates, and accounting for burdened labor multipliers. By factoring in productivity rates, crew compositions, and job-specific risk variables, contractors can safeguard profit margins and eliminate costly underbidding errors.
Pre-Estimation Project Scope and Resource Requirements
Establishing a reliable construction labor estimate demands rigorous preparation, access to standardized historical data, and a complete understanding of project design documents. Estimators must systematically gather all architectural blueprints, structural engineering specifications, and local municipal guidelines before calculating any financial figures.
- Essential tools and resources: Digital takeoff software, historical cost databases, localized wage determination sheets, and current union or open-shop collective bargaining agreements.
- Prerequisite knowledge: Proficiency in construction blueprint reading, mastery of assembly-based estimating techniques, and familiarity with local building codes, trade jurisdictions, and prevailing wage mandates (such as Davis-Bacon Act requirements).
- Benchmarks and metrics: Industry-standard net profit margins for general contractors generally range between 5% and 10%, while labor burdens typically add 30% to 50% on top of base hourly wages to cover taxes, insurance, and benefits.
Step-by-Step Construction Labor Cost Calculation
Step 1: Perform a Detailed Work Breakdown Structure (WBS) Analysis
Deconstruct the architectural and structural drawings into distinct, measurable construction divisions aligned with the Construction Specifications Institute MasterFormat standards. Break down every phase of work—such as concrete formwork, framing, drywall installation, and electrical rough-in—into discrete installation tasks. Do not lump entire trades together; isolating micro-tasks allows you to assign specific productivity rates and craft levels to each line item.
Pro-Tip: Review past project change orders during your WBS analysis to identify historically underestimated installation tasks and account for recurring site bottlenecks.
Step 2: Establish Base Wage Rates and Calculate Labor Burdens
Determine the exact hourly gross wage for each worker classification needed on the jobsite, ranging from apprentices and journeymen to foremen and project superintendents. Multiply the base wage by your company's calculated labor burden factor, which includes statutory costs like Federal Insurance Contributions Act taxes, Federal and State Unemployment Taxes, workers' compensation insurance, and employer-sponsored health insurance or retirement contributions.
Warning: Using generic national average wage rates will guarantee inaccurate bids; always pull localized wage data specific to the exact zip code of the jobsite.
Step 3: Calculate Crew Productivity Rates and Man-Hours
Estimate the total labor hours required to complete each task by dividing the total quantity of work by the expected production output per hour. Consult your historical production logs or industry-standard estimating manuals to find productivity benchmarks for specific crews. Adjust these baseline rates based on job-specific site constraints, such as restricted urban access, extreme weather conditions, multi-story vertical transport challenges, or complex architectural geometry.
Pro-Tip: When dealing with unfamiliar subcontractors or new crews, apply a 10% to 15% inefficiency contingency to your calculated man-hours during the mobilization and learning curve phases of the schedule.
Step 4: Aggregate Direct Labor Costs and Apply Overhead Margins
Multiply the total adjusted man-hours for each task by the corresponding fully burdened hourly rate to arrive at the direct labor cost for every division. Sum all divisional labor totals to establish the prime labor cost baseline for the entire project. Finally, add your corporate overhead allocation percentage and target profit margin to the baseline to generate the final proposed labor figure for your client's bid proposal.
Estimating Labor Costs: Key Components for Accurate Bids
Construction Labor Estimating Parameters and Burden Components
| Component Category | Description | Typical Financial Impact / Multiplier |
|---|---|---|
| Base Hourly Wage | Direct compensation paid to the craft worker per hour worked. | Varies by trade and geographic region ($25 - $75+/hr) |
| Mandatory Payroll Taxes | Employer contributions for FICA, FUTA, and SUTA. | Approximately 8% to 10% of base wages |
| Workers' Compensation | Insurance coverage for workplace injuries, varying by trade risk. | 5% to 35%+ of base wages (highest for roofing and steel erection) |
| Fringe Benefits | Health insurance, pension contributions, and union training funds. | 15% to 30% of base wages |
| Total Labor Burden | Combined multiplier applied to base wages to find true labor cost. | 1.30 to 1.50+ multiplier over base pay |
Common Construction Estimating Failures and Field Fixes
- Failure: Failing to account for overtime premiums when schedule compression forces weekend or night shifts.
- Root Cause: Assuming linear productivity and standard hourly rates throughout accelerated project timelines.
- Actionable Fix: Calculate overtime premium rates (typically time-and-a-half or double-time) separately and factor lower productivity rates associated with fatigued workers into extended shift calculations.
- Failure: Overlooking the learning curve impact on newly formed or large crews.
- Root Cause: Applying peak steady-state productivity rates from day one of the project.
- Actionable Fix: Create a phased productivity curve that assumes lower output during the first 15% of project execution while crews organize and establish site rhythm.
- Failure: Neglecting travel time, per diem, and non-productive mobilization hours for out-of-town projects.
- Root Cause: Estimating purely on installation man-hours without evaluating logistics.
- Actionable Fix: Add explicit line items for travel allowances, lodging, daily per diem, and equipment staging time before finalizing remote bids.
Frequently Asked Questions
How do I calculate the labor burden for my construction workers?
To calculate the labor burden, sum all annual employer-paid taxes, insurance premiums, and fringe benefits, then divide that total by the total annual base wages paid to your workforce. Convert this resulting percentage into a multiplier (for example, a 35% burden equals a 1.35 multiplier) and apply it directly to base hourly wage rates during estimating.
What is the difference between direct labor and indirect labor in construction?
Direct labor consists of craft workers who physically install materials and build the project on-site, such as carpenters, electricians, and laborers. Indirect labor includes supervisory and administrative personnel whose time benefits the entire jobsite generally, such as project managers, superintendents, and safety coordinators.
How do weather conditions affect labor cost estimates?
Adverse weather conditions reduce daily worker productivity through mandatory rest breaks, lower dexterity during cold snaps, heat stress slowdowns, and site cleanup delays. Professional estimators build weather contingency days and productivity loss factors into their project schedules and labor budgets based on historical meteorological data for the region.
How often should construction labor rates be updated?
Construction labor rates should be reviewed and updated quarterly to account for sudden fluctuations in local wage demands, changes in workers' compensation experience modification rates, and escalating material-driven labor dependencies. Relying on cost databases older than six months frequently results in severe underbidding due to inflation and shifting labor market supply.
Implement advanced construction estimating software and rigorous historical tracking today to protect your profit margins and submit competitive, accurate bids on every project.
